Building Back Better
It started with loss, but will end with growth

On the night of the 13th of February 2023, Hawkes Bay was severely affected by Cyclone Gabrielle. Our region saw extensive flooding that resulted in lost lives and livelihoods. Village Baptist was also affected, losing the church offices, four kids’ ministry rooms, and a kitchen. Parts of our system providing drinking water were also contaminated, while extensive silt deposits were left across the church site.

With a desire to rebuild in such a way that Village Baptist didn’t just get what it had but would be ‘set up’ for the next 20 years of ministry growth, the Building Back Better plan emerged. To discover more about that plan, and how things are progressing, please check out the posts below.

The latest Updates

30 Aug: And… It’s Gone!

Yesterday (29th August) the church cottage was finally lifted onto two trucks, cut down the middle, and relocated to its…

28 Aug: On the Road Again

While stage one of our Building Back Better project is largely complete, things are still moving forward. Recently we’ve seen…

02 Aug: Well… how about that!?

Last week we had the final run to the finish line. During that week, we saw (just about) everything completed…

19 Jul: The Downhill Slope

With one week left from today, we’re officially on the downhill slope for stage one of our Building Back Better…

16 Jul: It’s getting Close!

The painters have been hard at work across the last week, and have (just about) finished all the painting that…

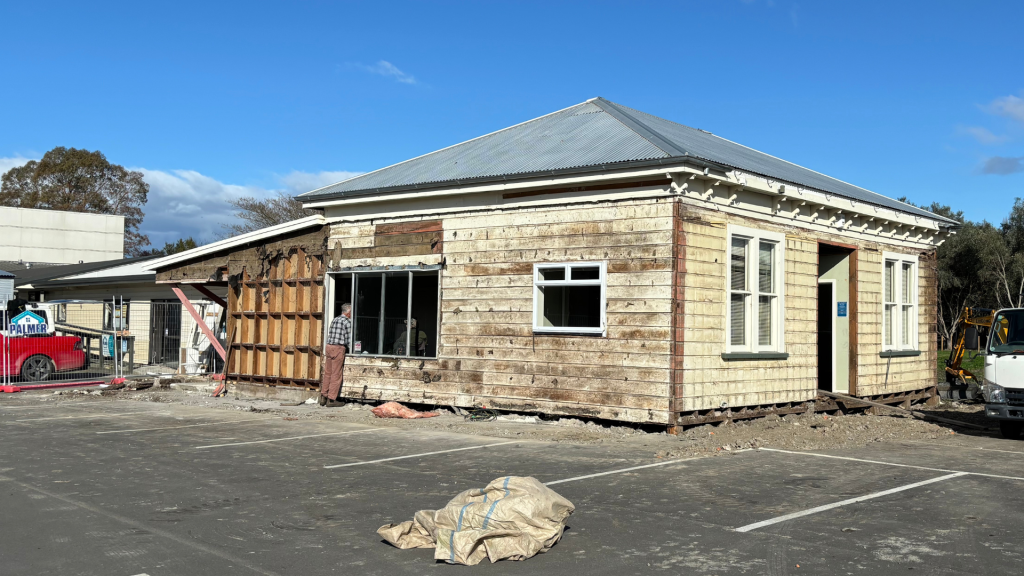

02 Jul: What lies beneath

The biggest visible change this week has been the preparation of the Church Cottage for removal. As the ‘modern’ additions…

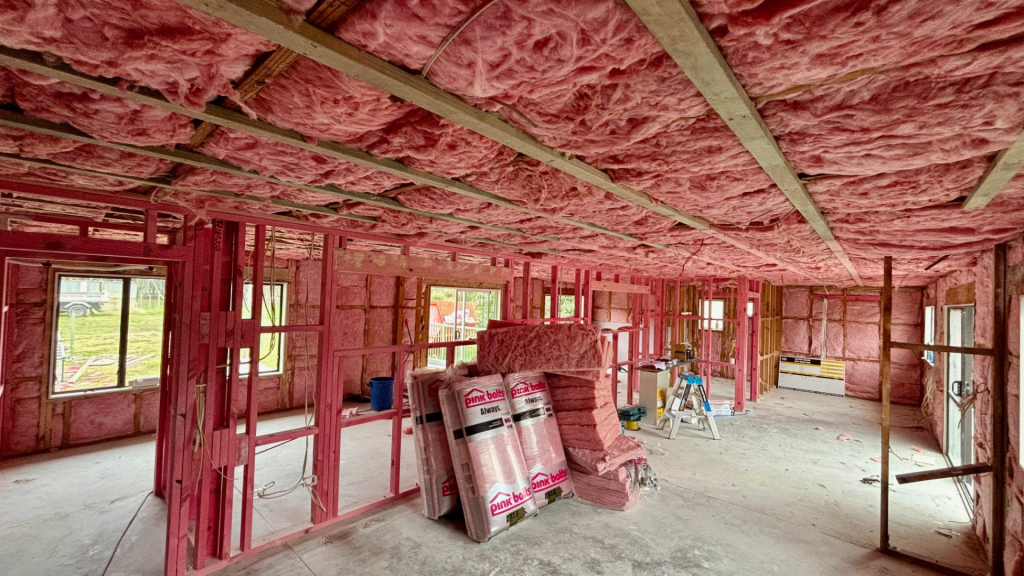

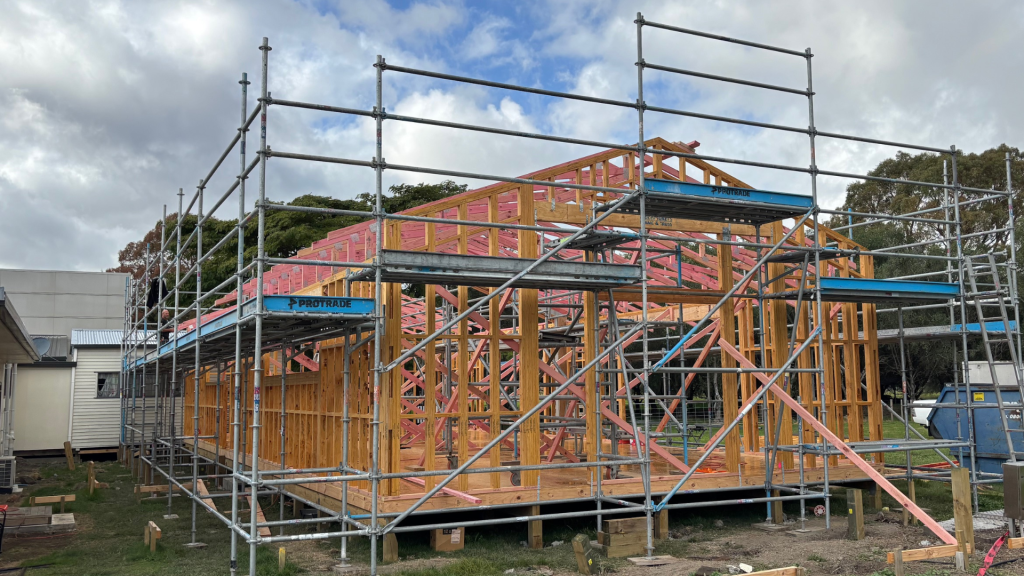

13 Jun: candyfloss Wonderland

Between the pink wood of the new partitions and the pink bats installed between, our ministry center has begun to…

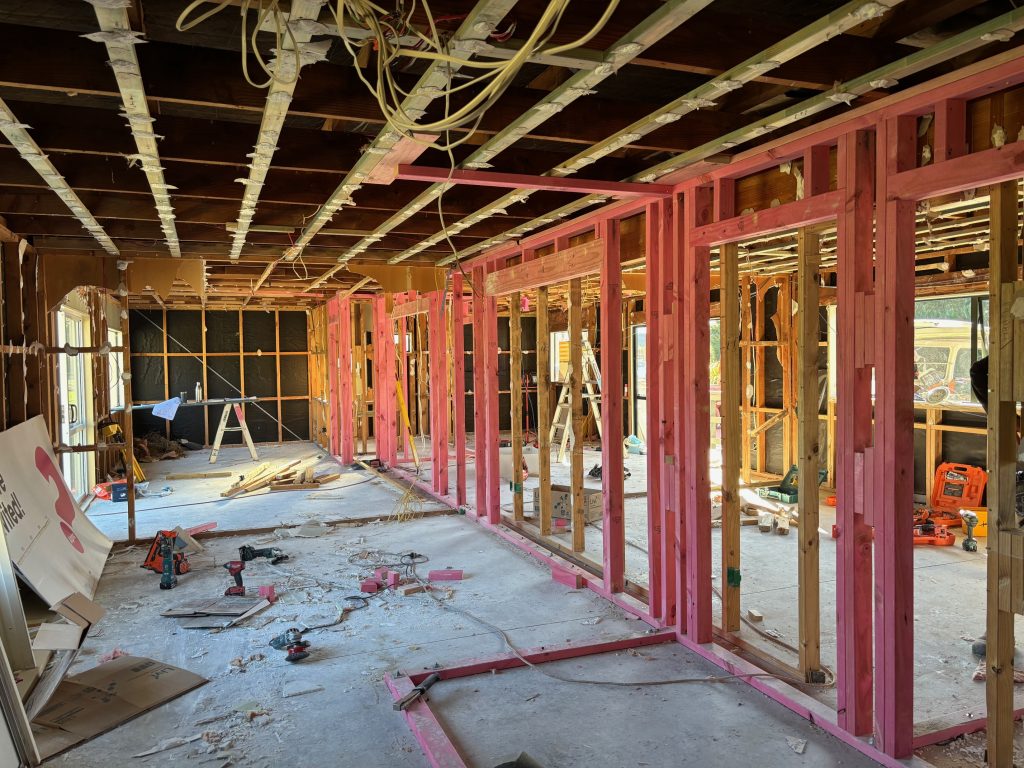

30 May: Out with the old

The builders officially began work on Monday this week! In the photo above, you can see the ministry center classrooms…

23 May: Planning for Next Week!

All go from Monday! Today, we had a site meeting with our builder and architects to plan the construction to…

16 May: Builders Onsite Next Week!

While it’s been a few weeks since the last update, there has been a lot going on behind the scenes….

01 May: Signed!

It would be fair to say that the journey to obtaining a signed agreement for the relocation of the church…

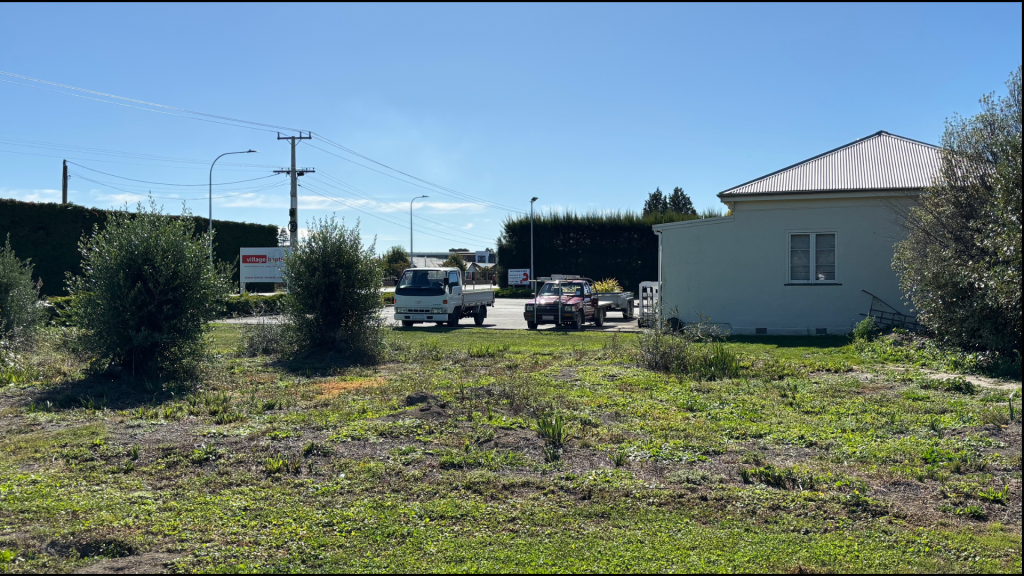

18 Apr: Final Relocation Meeting

It would seem that planning to move a cottage is quite an involved process! Today, the couple who have agreed…

16 Apr: The Tenders Are In

Today the tendering process closed and we have received confirmation from our architect that four construction companies have issued tendering…

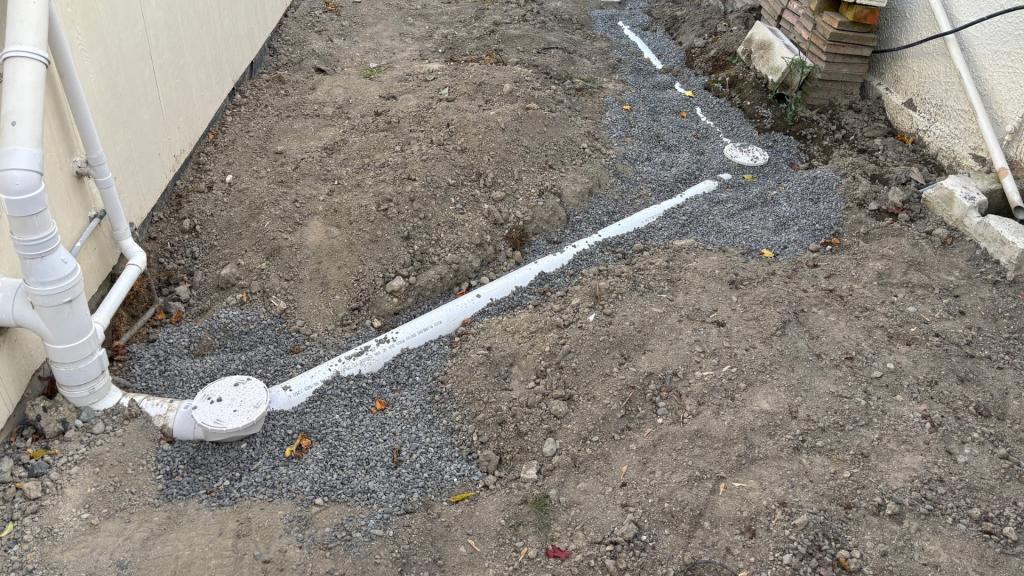

11 Apr: New Drains

Last year we managed to relocate the power and internet connections that previously terminated at the cottage. Today we completed…

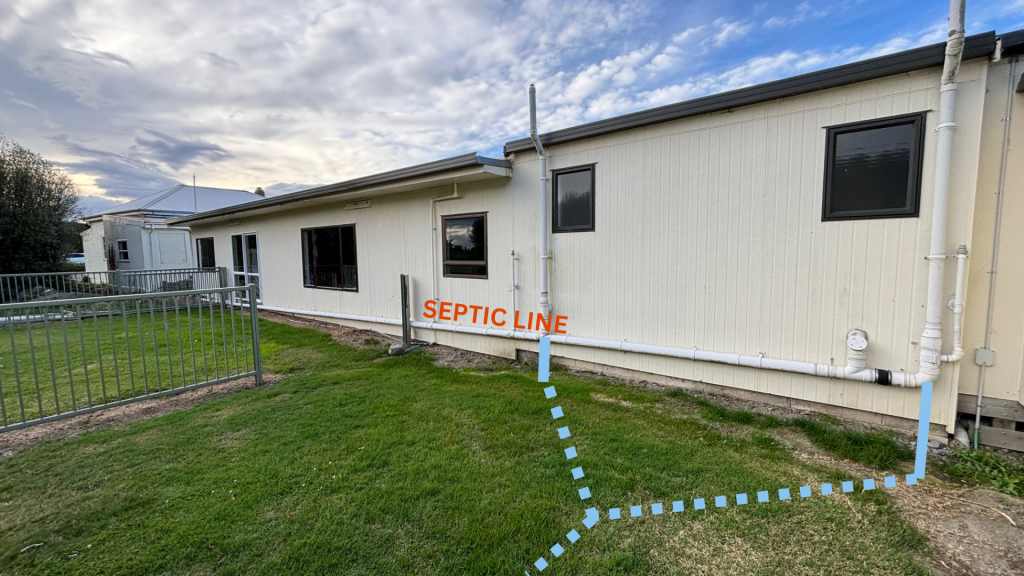

04 Apr: Drainage Plans

For a long time, we’ve had an issue with the present septic drains that run the length of the ministry…

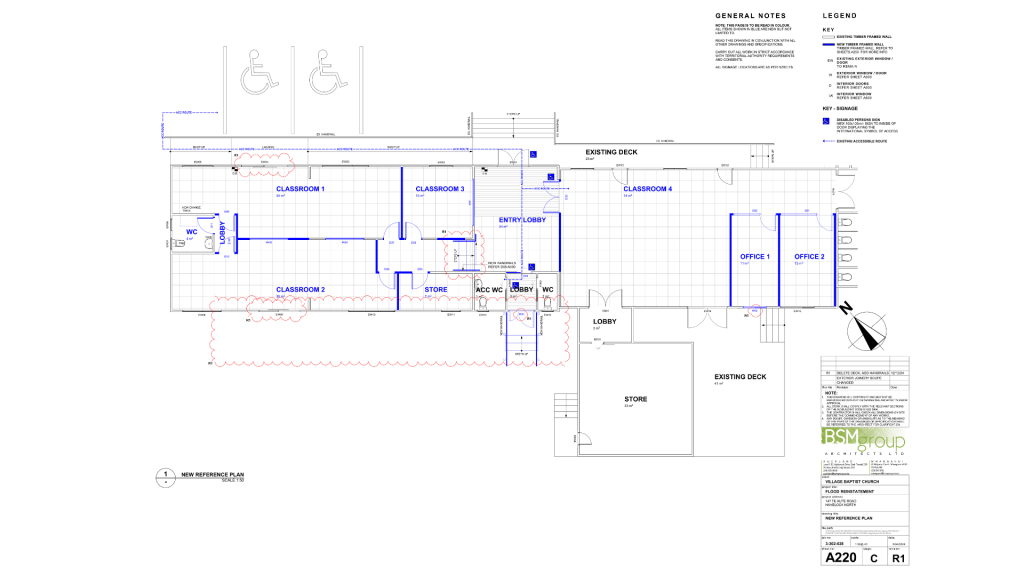

20 Mar: Out for Tender

After an extensive process of ‘back-and-forward’ discussing details such as light and light switch locations, alarm sensors and security camera…

09 Mar: Watering Sheep

Village Baptist has an arrangement with a local grazer in which they graze their sheep and cattle on our property….

22 Feb: Locating Drains

As the council will not allow us to site the classroom at right angles to the ministry center, we will…

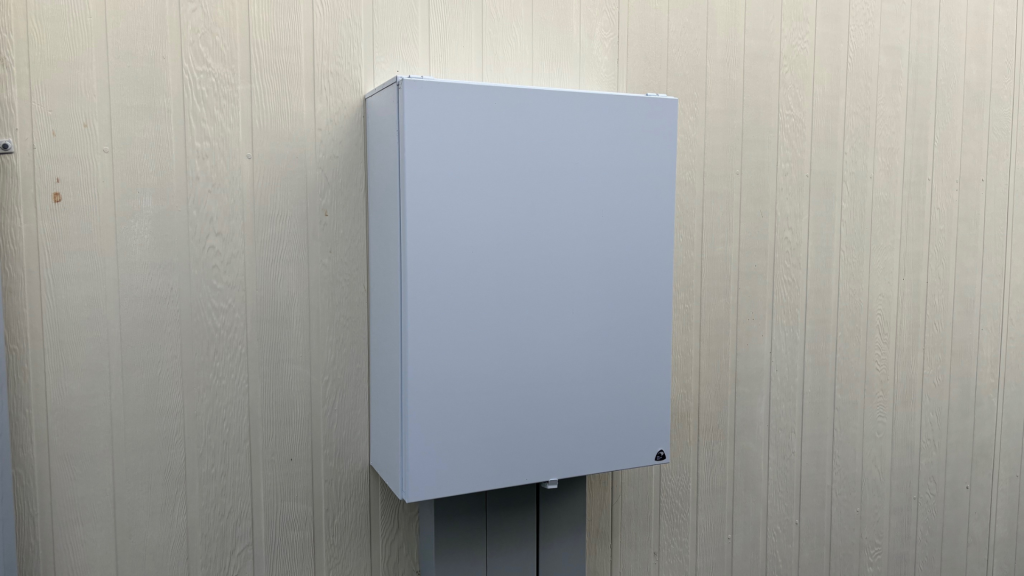

22 Dec: Disconnections

That new white box mightn’t look like much, but it’s progress! Because, regardless of whether the cottage is demolished or…

10 Dec: For Them Fundraiser

With three weeks’ notice, the church held its ‘For Them’ fundraiser on the 10th of December. The goal of this…

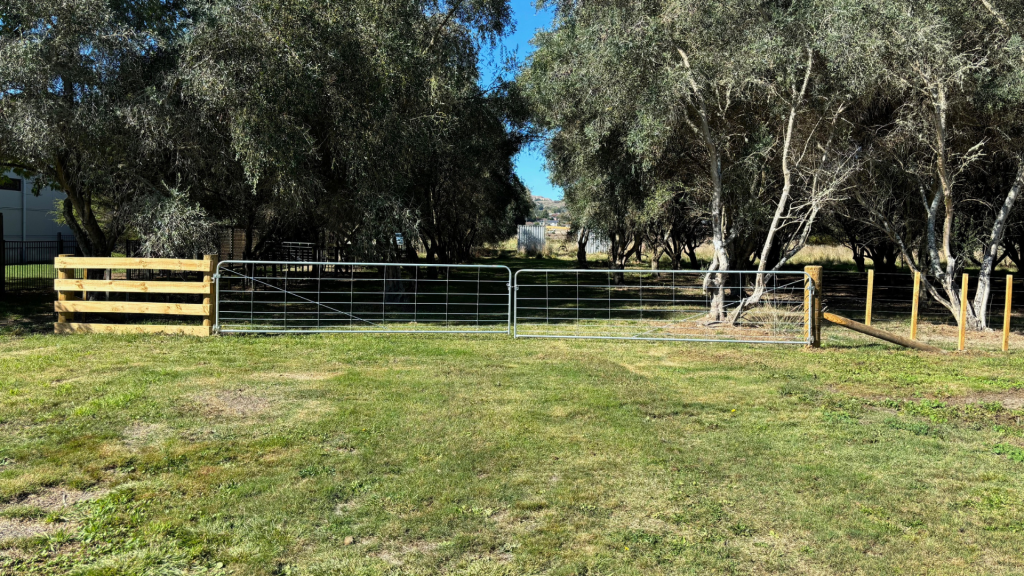

26 Oct: Fencing

For as long as the church has been on the present site, the property hasn’t been fully fenced. This has…

16 Jul: The Build Back Better Plan

Having communicated the preferred rebuild options with the church (here), we finally arrived at a point where we could present…

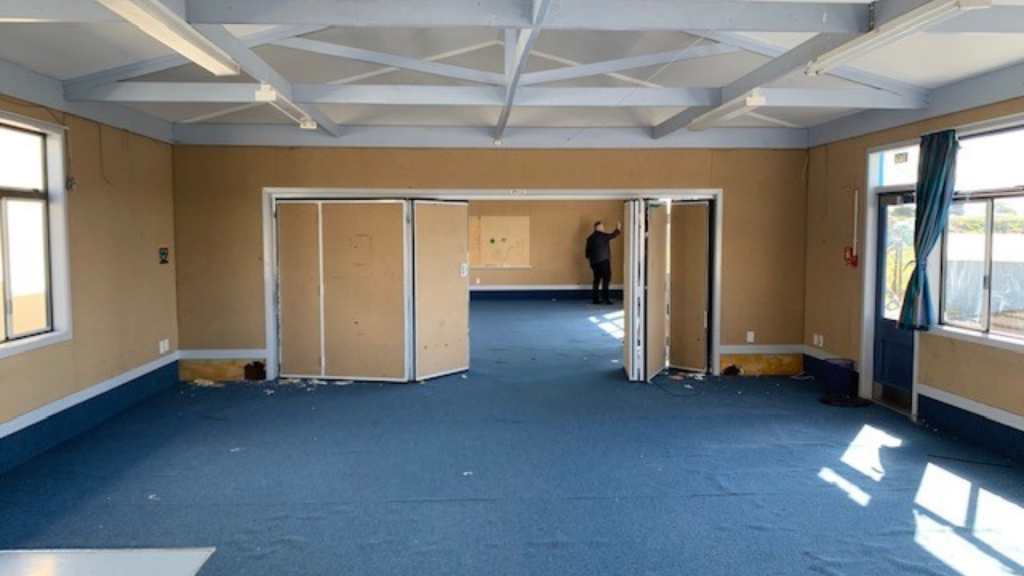

18 Apr: Emerging Plans

As our work shifted from the immediate cleanup to long-term planning, a ‘Property Development Committee’ was established. This committee was…

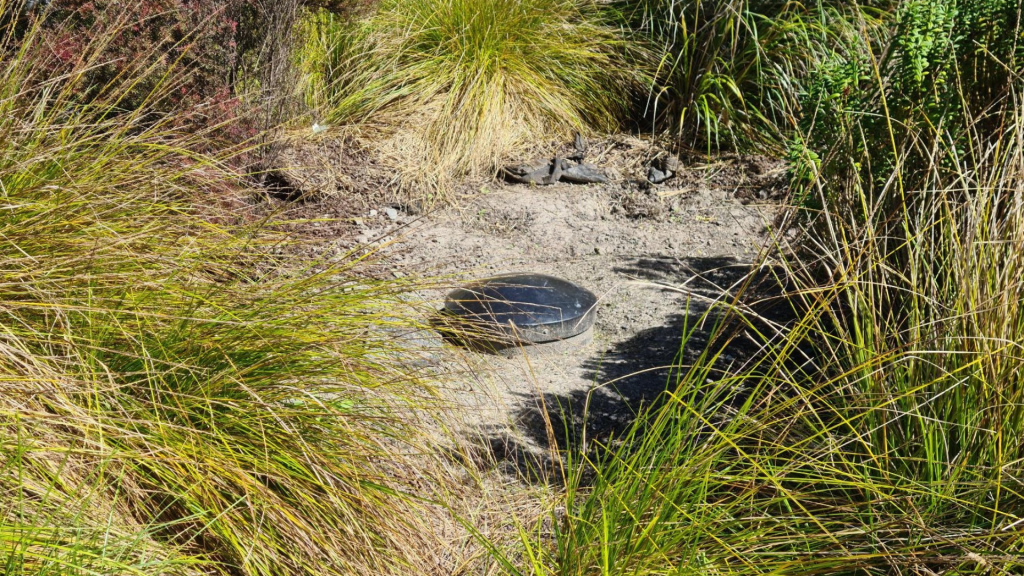

02 Mar: Short, Medium, and Long Term Plans

This week we were able to identify the source of the water contamination and develop a treatment plan. Unfortunately, we…

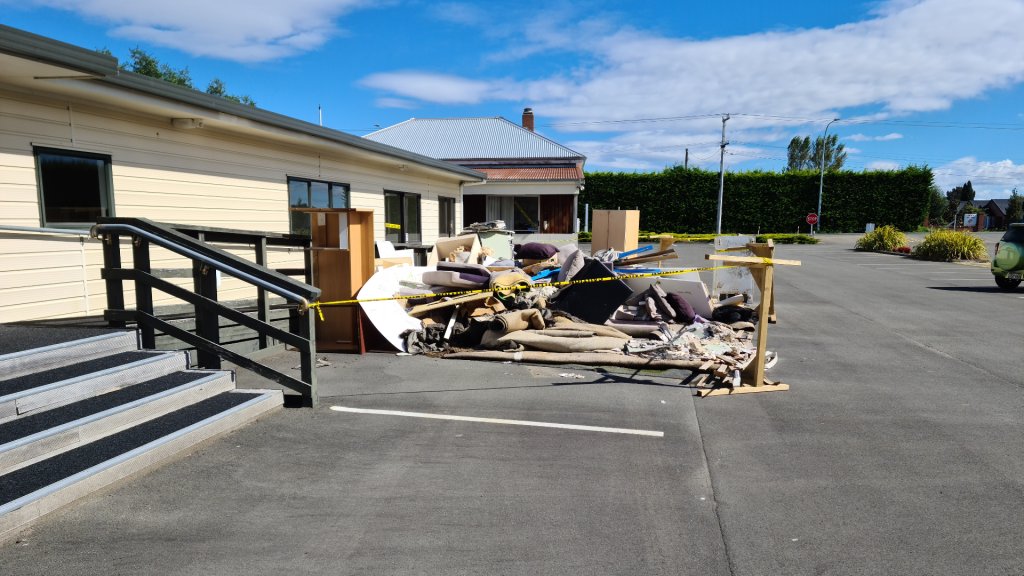

23 Feb: Ongoing Delays

The following week saw the first visit from our insurance assessor and the completion of property assessments by electricians, plumbers,…

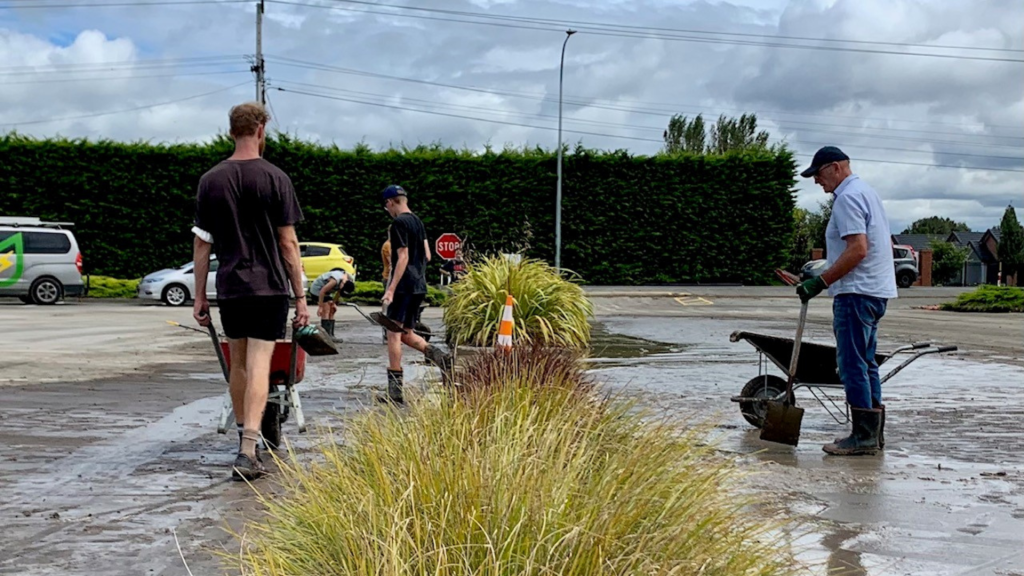

16 Feb: The Clean-up

Two days after the cyclone had passed, the waters had receded enough that we could begin our clean-up. With more…

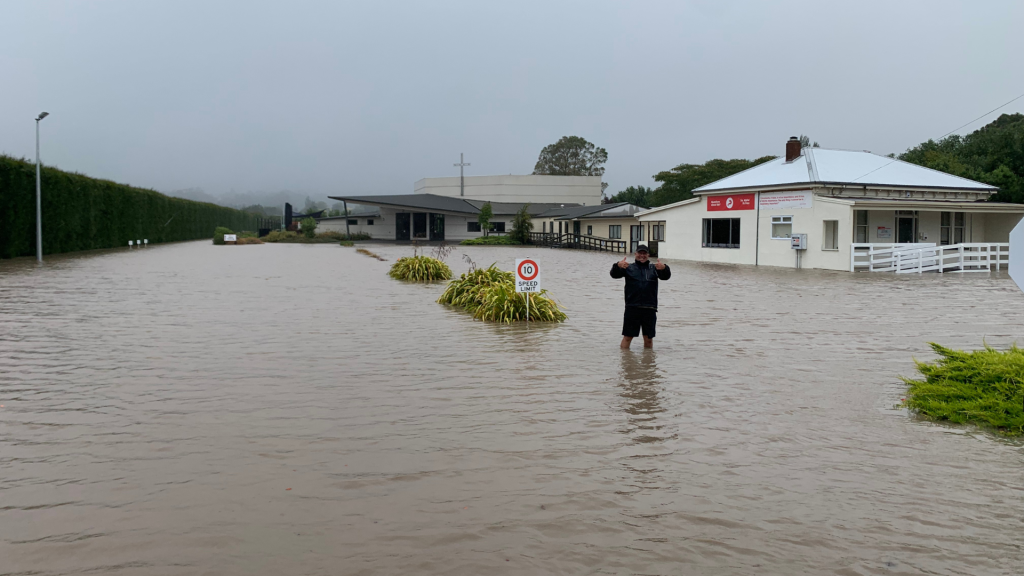

14 Feb: The Aftermath

The morning after the Cyclone cleared, a handful of church members thought to check on the church and arrived at…
